Items left outside a basic construction quote can add several lakhs to the final project cost, depending on the plot, external works, utility requirements, specifications and client changes. The compound wall, the gate, the utility connections, the wastewater system, the waterproofing nobody wrote down and the changes made once the walls are up all sit outside the per-sq.ft number most families sign on.
This guide lists the items a per-sq.ft quote usually leaves out, the pre-construction decisions that let those items grow, and how a Bill of Quantities (BOQ) closes the gap before you sign.
Every contractor in Kerala quotes in rupees per square foot. That number describes cost per unit of built area. It does not describe specification or scope.
Two contractors can quote the same rate for the same 2,000 sq.ft home and mean different things. One may have costed CPVC plumbing and FRLS copper wiring; the other, standard PVC pipe and wire of no stated gauge. The headline number is identical. The finished homes are not.
A per-sq.ft rate normally assumes the basic version of every material and does not say so. It also covers the building, not the property. The wall around the plot, the gate, the driveway, the drainage and the utility connections all sit outside it. This is not usually deception. Many contractors quote exactly what was asked. Most families do not know what to ask.
A quoted construction rate may exclude significant items outside the defined scope. Read the inclusions and exclusions rather than relying on the headline rate alone.

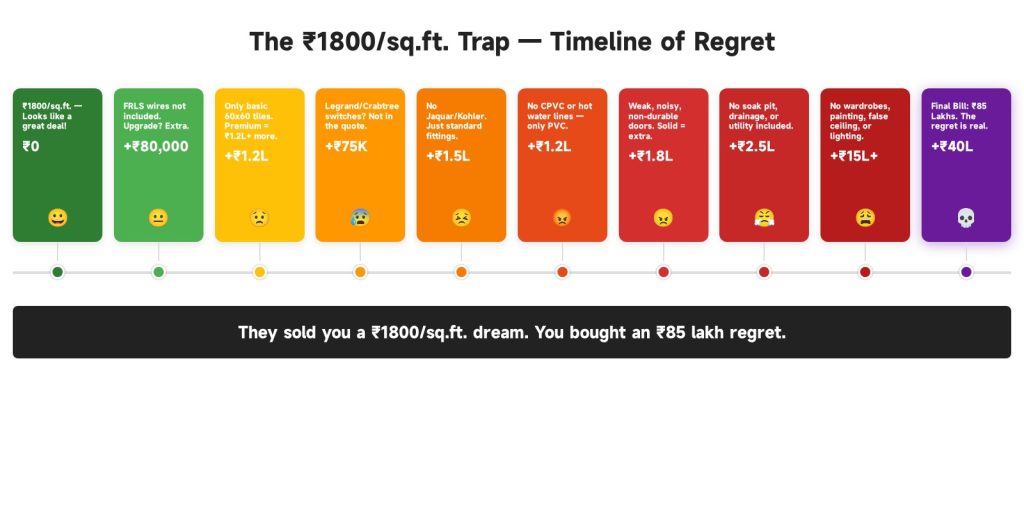

For the rate itself, the Kerala construction cost guide puts current construction cost at ₹1,800 to ₹3,500 per sq ft in 2026, set by finish level. Everything below sits on top of that rate.
Two kinds of gap show up when a quote is compared with the final bill. Scope gaps are items outside the building that the quote never covered. Specification gaps are items inside the building that the rate priced at a basic grade. Both need to be identified in the BOQ before the contract is signed, not discovered on site.
| Item | Usually in a basic quote? | What to check |
|---|---|---|
| Site preparation and excavation | Rarely | Most quotes assume flat, stable ground. Slope, fill or rock that needs machine breaking changes the cost. Ask for a separate line. |
| Soil investigation | Almost never | A real pre-construction cost. The result decides the foundation type. Without it, the foundation is designed on an assumption. |
| Building permit and approvals | No | Fees depend on building area, occupancy, the local body's calculation, applicable rules and project characteristics. |
| Electricity connection | No | Electricity connection and any required line/network extension should be identified separately rather than assumed to be included in the house-construction rate. |
| Water connection | No | A possible separate cost depending on the site and the connection requirement. |
| On-site wastewater system | No | Where a public sewer connection is unavailable, the project may require an approved on-site wastewater/septic system appropriate to the site and applicable rules. |
| Compound wall and gate | Almost never | Frequently outside a basic building-rate quote. Must be a separately identified BOQ head with its own specification. |
| Driveway and paving | Almost never | A separate cost head from the wall and gate. Paver, concrete or stone finish should be stated. |
| Site drainage | Often omitted | Compound gradient and rainwater routing. Water pooling at the plinth leads to rising damp and, in bad cases, settlement. |
| Foundation and plinth waterproofing | Often omitted | Should be named as a treatment, not assumed. |
| Terrace waterproofing | Sometimes, basic grade | The system and its application should be specified, not just "waterproofing". |
| Wet-area waterproofing | Sometimes, basic grade | Bathrooms, kitchens and utility areas. Specify the treatment and the height it is carried up the walls. |
| Anti-termite treatment | Sometimes | A cost and specification item. Pre-construction soil treatment is the stage that works preventively. |
| Landscaping | Almost never | Lawn, planters and boundary planting. |
| Interior fit-out | Never | Modular kitchen, wardrobes and loose furniture sit outside any structural quote and are usually the last large bill. |
| Item | Typical assumption in a basic rate | What to write into the BOQ |
|---|---|---|
| Flooring | Basic ceramic tile | Tile type, size, brand and rate per sq.ft for each room. |
| Wiring, switches and sockets | Unbranded wire, local switches | FRLS copper wire with gauge stated, and a named switch brand and series. |
| Plumbing lines | Standard PVC, not rated for hot water | CPVC or equivalent on hot-water lines, with the brand named. |
| Sanitary fittings | Local or unbranded grade | Jaquar, Grohe or Kohler, written in by model. |
| Doors | Hollow or basic flush doors | Door type by location: external, internal and wet-area. |
| TMT steel | Grade and source unstated | Grade and producer as specified by the structural engineer, BIS-certified. |
| Cement | Unstated | Cement grade/type as specified in the approved structural/BOQ specification. |
| Sand | "Sand" | M-Sand or P-Sand as specified for the particular application and approved BOQ/specification. |
| Painting | Single coat, basic grade | Brand, product line and number of coats, interior and exterior. |
Neither kind of gap is fraud. But once the roof slab is poured, your negotiating position is gone, and whatever gets added then gets paid at whatever it costs then.
Home construction budgets rarely fail during construction. They fail before it starts, in a decision that was unclear, assumed or skipped before the first trench was dug.
A contractor quotes a lump sum for 2,000 sq.ft, premium finish. You agree. At the plumbing stage you ask for Jaquar, Grohe or Kohler. The quote assumed something cheaper. Neither side is wrong, and you pay the difference.
This repeats with tiles, steel, electrical, painting and doors. A BOQ lists every item, brand, quantity and rate. With one, both sides know the scope. Without one, both sides guess, and the guesses are settled on site.
The quote covers the building. The compound wall, gate, driveway, wastewater system and utility connections sit outside almost every Kerala construction quote, not because the builder hides them but because the scope is the building, not the property.
The wall and gate, and the driveway, should each be a separate cost head in the BOQ. Their bills tend to arrive after the main construction account is settled. Utility connections are handled with the public utilities rather than the builder, and in semi-urban and rural plots around Trivandrum (Attingal, Nedumangad, Varkala, Pothencode and similar) the distance to the nearest line can make them the single largest item nobody mentioned at quote stage.
Ask each builder one question: is this for the building only, or for everything needed to move in? Then ask KSEB and KWA about your plot's connection status and distance to the nearest line. They are public offices and will tell you what your plot needs.
Within Trivandrum district, plots range from hard laterite to soft or filled ground, sometimes within the same neighbourhood. What your plot sits on decides the cost of site preparation and the foundation type.
A soil investigation is a real pre-construction cost and is strongly recommended for any plot that has been filled, sits near a water body or has visible slope. Foundation design must follow the actual soil investigation and structural design for the site. Without the investigation, the builder guesses: over-builds and charges more, or under-builds and leaves structural risk.
Ask for a separate BOQ line for site preparation and excavation, and ask whether the quote assumes flat ground and stable soil. If your plot has any slope or fill, that assumption will not hold.
Steel, cement, sand and aggregate prices move during a construction cycle. A build crosses financial quarters and a monsoon season, and material prices at the end of the build are not the prices at the start.
Who absorbs a change depends on the contract. Price changes become a client risk when the contract or BOQ does not clearly state the rates, how long they are valid, how escalation is treated and what specification the rates apply to. Most Kerala quotes are silent on all four, and on a vague per-sq.ft contract the contractor issues a variation order and the client pays.
The protection is a BOQ with stated unit rates, a stated validity period and a written escalation clause. Specify the sand too: M-Sand or P-Sand as specified for the particular application and approved BOQ/specification, rather than "sand".
Kerala buildings live through a long monsoon every year. Water management around and inside a building is a structural necessity here, not an optional upgrade.
A contractor quote may include basic terrace waterproofing. It rarely names the system, and it almost never includes foundation waterproofing or site drainage as separate specifications. If rainwater has no path away from the plinth, it pools against the foundation, and over a few monsoons that produces rising damp, efflorescence and, in bad cases, differential settlement.
Waterproofing and drainage should be specified in the BOQ by location and treatment: foundation and plinth, terrace, wet areas and the compound gradient. Fixing any of these after handover means demolishing finished work to reach the problem.
Kerala's warm, humid climate suits subterranean termites. Left untreated, a colony can damage timber, door frames and finished woodwork within a few years of occupation.
Treatment has two stages. Pre-construction soil treatment is applied before the plinth concrete is poured. Post-construction perimeter treatment is applied after flooring. "Pest control" as a vague inclusion does not mean pre-construction soil treatment, which is the only stage that works preventively. The line item should name the chemical, the application method, the coverage area and the warranty terms the applicator actually offers.
Design changes during construction are the most unpredictable cost in a build and the most expensive per unit of change. A wall moved on a drawing costs a revision. The same wall moved after the foundation is poured costs demolition, rework and re-coordination across trades. Changes become progressively more expensive once foundations, masonry, MEP routes or finishes are executed, because each stage locks in the ones before it.
Families who start construction with incomplete drawings spend the build paying for decisions they could have made on paper. The prevention is a complete, approved design: floor plans, elevations, sections and a room-by-room specification signed off before excavation. For the construction-stage errors that follow, see building mistakes in Kerala.
You agreed to a vitrified tile at a stated rate. At the tile shop you see an imported large-format tile at a much higher rate. Then the paint upgrade, the teak front door, the quartz counter, the touch-panel switches. Each feels small on its own. Together they move the budget well above plan, and none of them was in the contract.
Decide the finish level before construction starts and write it down: tile rate per sq.ft, plumbing brand range, paint brand, door type, steel grade. Everything that says "standard" should have a specification next to it.
A transparent quote is not a higher quote. It is a complete one.
A Bill of Quantities lists every material, brand, quantity, unit rate and total before work begins, as a commitment rather than a description. When the BOQ names the steel grade, the cement grade/type as specified in the approved structural/BOQ specification, and M-Sand or P-Sand for each application, the contractor cannot substitute without the client's written approval and a rate adjustment. When it says Jaquar, Grohe or Kohler for the sanitary fittings, there is no ambiguity on site about what gets installed.
A BOQ also forces every decision to happen before construction starts, when decisions cost the least. The tile is chosen on paper, not on the slab.
This is how Rzian Homez works: architect-led Design + Build under one accountable team. Every project begins with a site visit before the final BOQ is prepared, so topography, soil and drainage direction are known before anything is priced. Site preparation and external items are identified separately rather than folded into a per-sq.ft rate. Waterproofing and drainage are clearly specified in the BOQ where applicable. Payments are linked to construction stages rather than front-loaded, so the client keeps control through the build. The construction programme is 270 days. House construction in Trivandrum describes how that programme runs on the ground.
A per-sq.ft construction rate is not the same as the final all-in project budget. External works, utilities, approvals, upgrades and client changes must be budgeted separately.
If you already have a quote in hand, the free BOQ audit checks it line by line and flags what is missing, what is underspecified and what is likely to cost more than quoted. If you are still planning, the home cost calculator gives a starting number for your district and finish level.
There is no single figure. Items left outside a basic construction quote can add several lakhs to the final project cost, depending on the plot, external works, utility requirements, specifications and client changes. The largest contributors on most projects are the compound wall and gate, the driveway, utility connections, waterproofing and site preparation, followed by finish upgrades and change orders. The way to know your number is to have each identified separately in the BOQ before you sign.
In most cases, no. Contractor quotes cover the main structure only. The compound wall and gate, the driveway and paving, and landscaping are almost always excluded and should each be written into the BOQ as a separate cost head with its own specification before work begins.
Typically the structure, foundation, walls, roof slab, plaster and finishes at a basic assumed specification: basic ceramic tile, unbranded wiring, local-grade switches, standard PVC plumbing and unbranded sanitary fittings. It does not normally include the compound wall, gate, wastewater system, utility connections, permit fees or interior fit-out. The Kerala construction cost guide sets out the current rate range by finish level.
Ask for a line-item BOQ with quantities and unit rates stated, a validity period for those rates, and a written clause on how escalation is treated. Price changes become your risk only when the contract is silent on these points. Vague per-sq.ft quotes pass the risk back to you mid-construction through variation orders.
It is not always a legal requirement, but it is a genuine pre-construction cost that should be in the budget, particularly in Trivandrum where plots range from hard laterite to soft or filled ground. Foundation design must follow the actual soil investigation and structural design for the site; without it, the foundation is designed on a guess.
Where applicable, yes. Waterproofing and drainage are clearly specified in the Rzian Homez BOQ by location and treatment, and every project begins with a site visit before the final BOQ so that the compound gradient and rainwater routing are planned before excavation rather than added afterwards.
WhatsApp Rzian Homez for a transparent BOQ.
Share your plot details and requirements. We will give you a full cost estimate -- structure, utilities, waterproofing, compound wall, and exterior -- so the number you see is the number you pay.
